SB 330’s housing review framework can be very different from what most homeowners and small‑scale builders expect – especially if you’re planning a modular home in California.
In this post, I’ll walk through how the SB 330 California Housing Crisis Act works in real projects and what it meant for our modular home build.
Under California law, a housing development project generally includes residential‑only projects, mixed-use developments where a majority of the square footage is residential, and certain types of supportive or transitional housing. Many of the protections discussed below apply specifically to these qualifying projects. Many cities also interpret these protections to apply to certain single‑unit projects when they qualify under SB 8’s clarifications, but this can vary by jurisdiction.
In a previous post, we shared how our originally approved plans expired during the COVID shutdown. When we resubmitted, we were told the lot was now considered too small for a single‑family home. However, the local jurisdiction indicated the project could move forward if it was redesigned as a multi‑family project and resubmitted under the California Housing Crisis Act of 2019.
Our project manager resubmitted the application under this legislation, and it was approved.
At the time, we understood the law in very simple terms – as a California measure intended to increase housing production for residential use. We didn’t realize it creates a structured review framework with built‑in protections, or how much it could influence schedules, decisions, and even how development‑related costs are calculated.
Looking back, a clearer understanding of how this legislation applies would have changed several of our decisions. Homeowners should take the time to become familiar with the specific details of this legal framework and the local practices that go with it, stay actively involved throughout the preliminary application process, and be prepared to help clarify how the law applies – both for the project manager’s team and the local agencies.
How California’s Housing Development Process Works Under the SB 330 California Housing Crisis Act
California housing laws don’t operate in isolation. Instead, they fit together to control three key parts of a proposed housing development:
When rules are set
How projects are reviewed
How long agencies have to respond
Senate Bill 330 plays a central role in this framework, but it operates alongside other laws, including the Housing Accountability Act and the Permit Streamlining Act. Understanding how these pieces fit together is what allows a project to move forward effectively.
These provisions are part of SB 330 and are intended to streamline housing development review and establish objective criteria at the time of a preliminary application.
For modular home projects, understanding this bigger framework upfront can help you align your factory‑built design and on‑site work with the local planning criteria from the very beginning.
SB 330 Application Process: When Development Standards Are Established
One of the most important aspects of SB 330 is that it ties a project to the conditions in place at a specific point in time.
In our research, once a complete preliminary application is submitted, the criteria that govern your project – such as height limits, setbacks, and other local ordinances – are generally tied to the date of submittal, not when the project is later approved. This means cities typically cannot apply new or revised provisions after that point.
Because this is not always clearly recognized or consistently applied, it’s important to confirm this early with the local agencies.
SB 330’s original provisions were set to sunset on January 1, 2025. SB 8 extended those protections through January 1, 2030.
For homeowners and small‑scale builders working on qualifying new housing development projects, this means timing matters. As part of the application process, the date your application is submitted can directly impact which standards apply to your project – and whether they can change later.
SB 330 Housing Development Review: How Projects Are Evaluated
As part of California’s housing framework, SB 330 shifts project review toward objective criteria.
Instead of relying on subjective interpretation by local agencies, decisions are intended to be based on measurable benchmarks. SB 330 prohibits cities from using subjective reasons – such as “it doesn’t fit the neighborhood’s character” – to deny a project. They are limited to applying criteria that are clearly defined, consistently applied, and known in advance.
One of the most important benefits is that key project parameters are established early. Factors such as height, setbacks, and floor area ratio (FAR) – essentially the amount of square footage you are allowed to build relative to your lot size – are influenced by what was in place at the time the preliminary application was submitted.
However, this does not eliminate all local discretion. Agencies can still apply objective ordinances already in place – such as zoning and design policies – but generally cannot introduce new or changing provisions after the preliminary application is submitted and deemed complete. These protections do not eliminate environmental review requirements under the California Environmental Quality Act (CEQA); they mainly govern how and when the project is processed.
In our case, we made several revisions to our plans in response to city feedback – lowering height, modifying design elements, and adjusting window configurations. Looking back, some of those changes likely would not have been required.
Pro Tip: A lot of modular buyers choose a factory plan, lock in their design, and can get blindsided by city ordinance changes. Once you’ve aligned your modular home design with local height, setbacks, FAR, etc., locking in development standards at the preliminary application date can help you avoid expensive redesigns later.
Pro Tip: Because modular homes have less flexibility for last‑minute structural changes, SB 330’s emphasis on objective standards and early parameter‑setting is especially valuable – you want those rules clear before your home is built in the factory.
SB 330 Limits on Hearings for a Housing Development Project
One aspect of SB 330 that isn’t always obvious is that it limits how long a project can be delayed through public hearings. SB 330 generally prohibits local agencies from holding more than five hearings. These protections apply to qualifying housing projects and do not automatically apply to every residential project or permit.
At the same time, SB 330 – working alongside the Housing Accountability Act – limits how and when a project can be denied. If a qualifying project meets applicable objective criteria, a local agency generally cannot deny it based on subjective concerns or public opposition alone.
Denial is still possible, but only under specific conditions supported by written findings and evidence, such as impacts to public health and safety, conflicts with other laws, or inadequate infrastructure.
For modular projects that sometimes attract extra neighborhood attention, these limits on hearings and subjective objections can be especially important once your design meets the objective standards.
Application Review Timeframes for Housing Development Projects

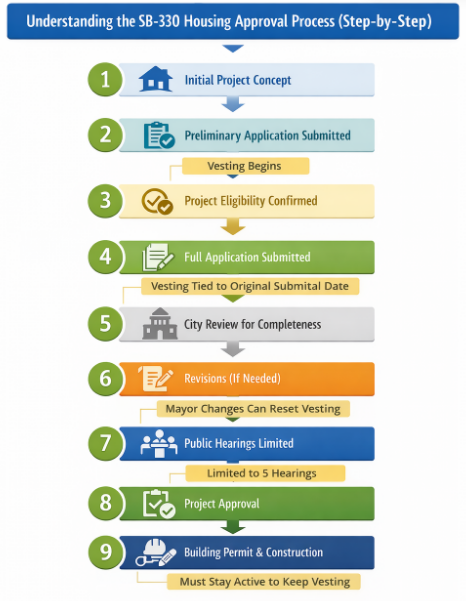

This is a simplified view of a typical SB 330 housing approval process; specific steps and timing can vary by jurisdiction
Another part of the system controls how long local agencies have to respond once you submit your application.
Under California’s Permit Streamlining Act (Government Code § 65921), as reinforced by SB 330, local agencies must follow defined timeframes at each stage of review. These requirements are intended to prevent projects from being delayed indefinitely and to create a more predictable review cycle.
At a high level, the sequence generally unfolds as follows:
Completeness Review (30 days):
After application submittal, the agency has 30 days to determine whether the application is complete. If the application is deemed incomplete, the agency must provide a complete list of missing items based on its pre‑existing checklist. They cannot request new types of information later in the review that were not identified at this stage. If they do not respond within that window, the application may be deemed complete by default.
Consistency Review (30–60 days):
Once deemed complete, the agency must identify any inconsistencies with applicable criteria within a defined timeframe. If they miss this deadline, the project may be treated as consistent.
Final Decision (typically 60–90 days):
After required environmental review is completed, the agency must approve or deny the project within a set period, depending on the project type.
However, there is no notification when these deadlines are missed.
There is no alert that says, “your project just became protected.” Most jurisdictions do not track or notify applicants when these deadlines pass, which makes it important for both the project manager and homeowner to understand these timeframes and actively track agency responses.
Vesting Explained: What Is Determined at the Time of Application
Once those timelines establish when an application is considered complete, the next question is what that means for your project under the SB 330 California Housing Crisis Act.
Vesting means your project is evaluated based on the conditions in place at the time your complete preliminary application is submitted and deemed complete – not the date it is later approved. That point in time becomes the reference for how the project is reviewed going forward.
In addition to the criteria that govern your project – such as height limits, setbacks, and local ordinances- certain project‑related fees and conditions may also be tied to that same point in time, but not all costs are fixed. For example, if a local agency has already adopted automatic adjustments, such as increases tied to the Consumer Price Index (CPI), those adjustments can still apply.
In our case, our preliminary application was submitted in 2023. Based on that timing, we are requesting that project costs be aligned with 2023 rates rather than current 2026 rates, with any adjustments limited to previously adopted automatic increases.
This is why understanding both timelines and vesting is critical – they function together to define how and when your project is evaluated.
Take‑away: If factory prices or local construction costs are climbing, tying certain fees to your preliminary application date can help keep the overall modular home budget closer to what you planned – subject to any previously adopted CPI‑based increases.
Maintaining Vesting in the SB 330 Application Process
Vesting is not permanent – it has to be maintained.
Once your preliminary application is submitted, there are a few key milestones to consider:
180‑Day Full Submittal: A complete project application must be submitted within 180 days.
Start of Activity: On‑site activity must begin within a defined timeframe.
If those milestones are missed, the project can lose those protections and become subject to current rules and costs.
When a Housing Development Project Is Considered Started
For modular projects, starting construction does not refer to when the home is built in the factory – it refers to on‑site activity.
Excavation, foundation installation, and passing a valid inspection are typically what establish that the project has officially started. From that point, ongoing progress must continue to keep the project active.
Most local agencies use inspection activity as verification that the project is progressing; however, each jurisdiction defines activity differently. In our case, the project remains active as long as an inspection occurs within 365 days, although other jurisdictions may require more frequent activity.
If activity lapses, those protections can be lost.
Pro tip: If you are approaching an expiration deadline, requesting a general or progress inspection can often help keep the project active.

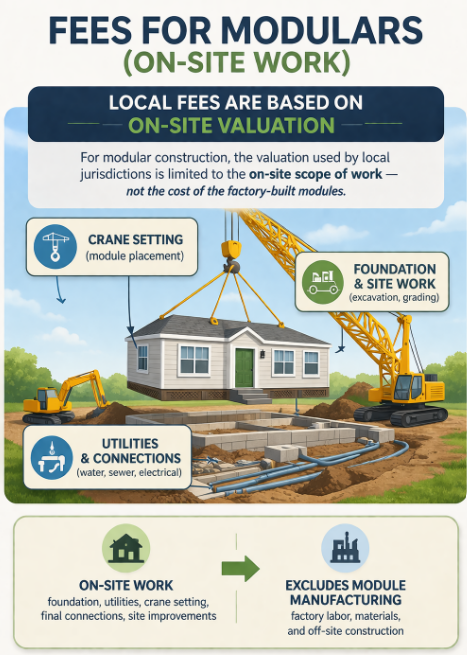

How Project Costs Are Calculated for Modular Homes
Local valuation practices can vary; always confirm how your city or county calculates modular fees
One of the most important – and often overlooked – aspects of modular construction is how project costs are calculated at the local level. However, keep in mind how project valuation is calculated can vary by jurisdiction and is not defined by SB 330. SB 330 and SB 8 set the framework for when certain fees are evaluated, but they do not tell your city exactly how to calculate the value of a modular home project.
Because modular homes are built and approved at the state level, the structural, electrical, and plumbing systems are typically reviewed outside of the local jurisdiction. As a result, local agencies often focus on the on‑site portion of the project, including the foundation, utilities, and installation.
This distinction matters because it affects how project valuation is determined. In some cases, local fees are intended to be based on the on‑site scope – and generally are not intended to include the cost of the factory‑built modules. However, how this is applied can vary by jurisdiction.
In our case, this became something we had to revisit after the fact. The city calculated fees based on the total square footage of the modular home through an automated system, rather than limiting the valuation to the on‑site scope. Had we better understood this approach earlier, we would have clarified upfront how project valuation was being determined.
This is one area where confirming how project valuation is calculated early in the process can make a meaningful difference.
Where SB 330 Helps a Housing Development Project – and Where It Doesn’t
SB 330 provides meaningful protections for qualifying housing development projects. It helps stabilize project standards, creates defined timeframes for agency response, and limits subjective decision-making during the review process. However, these protections do not automatically apply to every residential project or permit.
While SB 330 can improve predictability, it does not simplify the overall project.
It does not eliminate the need for coordination between the builder, the local agency, and consultants. It does not prevent delays caused by design revisions, changing site conditions, or agency interpretation. It also does not resolve project‑specific questions – particularly for modular construction – such as how responsibilities are divided between the factory and the local jurisdiction.
In our case, we still had to stay actively involved to keep things moving and to make sure the protections available under the law were being applied correctly.
For modular home buyers, these protections are most helpful when you use them to lock in standards early, clarify how fees will be calculated, and keep the project moving so your approvals don’t expire while the home is being built in the factory.
Pro Tip: Confirm How Project Costs Are Calculated
Before approvals are issued or project costs are finalized, confirm with each agency – including local utilities and special districts – how they are determining project valuation.
Clarifying this early can prevent costly revisions later and helps ensure those costs align with vesting from the start.
Pro Tip: If you are a senior, it is worth checking whether you qualify for property tax or school district‑related exemptions or adjustments. These can vary by location but may significantly affect your long‑term costs.
Pro Tip: If you are selling an existing home as part of your project, take time to understand how your property tax basis may transfer to your new home. In California, programs like Proposition 19 may allow you to carry over your existing tax basis, but there are specific timing and value considerations.
Final Takeaway
This legislation does what it was designed to do in important ways. It creates a more predictable structure, limits subjective decision‑making, and establishes clear timeframes that can help protect a project from unnecessary delays.
But it does not manage the project – your team does. And unless you understand how these protections operate, they may not be applied the way you expect.
Note: This content reflects our experience and research and is provided for general informational purposes only. It is not legal, tax, or professional advice. It is intended to summarize the major provisions of the law. Laws and local interpretations can vary, so applicants are encouraged to review the specific details to understand how they apply to their situation and to consult the appropriate professionals before making decisions.
Frequently Asked Questions
Does this law set project costs for a modular home?
The law can establish certain development‑related costs based on the date of the preliminary application. These typically include permit and processing charges, infrastructure impact costs, and utility connection or capacity charges. However, not all costs are fixed.
Does this law apply to utility companies and districts?
These protections generally apply to local agencies, including counties and special districts such as sewer and water providers. However, how they are applied can vary and should be confirmed with each agency.
What happens if your application expires?
If activity lapses, the project may lose those protections and become subject to current requirements and costs. Maintaining progress is important to preserve those protections.
Does SB 330 help modular home projects in California?
If your modular home qualifies as a housing development project, SB 330 and SB 8 can offer several protections. They help lock in many development standards and certain fees as of your preliminary application date, limit how many times your project can be sent back to public hearing, and push cities to rely on objective criteria rather than subjective opinions. For modular home projects – where designs are often finalized at the factory before local review is finished – these protections can make it easier to avoid late design changes and unexpected local cost increases, as long as you meet the eligibility criteria in the law and maintain your project’s active status.
